Skip to main content

Carbon reduction projects

A range of projects are underway to reduce the emissions of our estates and operations.

Carbon Reduction Projects

Explore the range of projects we're delivering alongside partners across and beyond the University to lower the carbon emisions of our organisation.

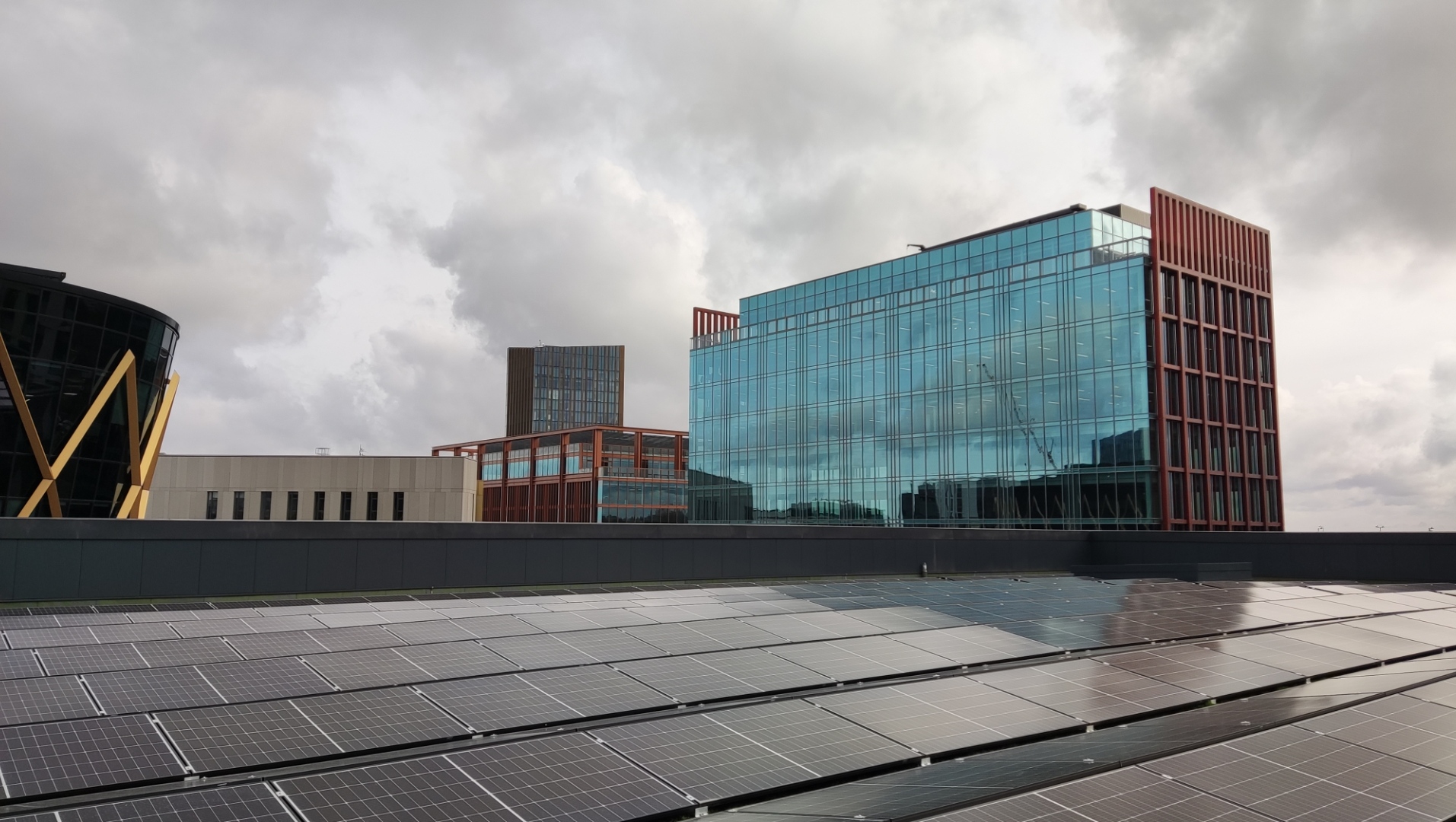

Solar Photovoltaic (PV) Project

Installing solar photovoltaic (PV) systems across campus.

What is the project?

As part of Newcastle University’s Climate Action Plan, and our target to increase the amount of renewable energy generation on campus, this project will install solar photovoltaic (PV) arrays on the rooftops of many of our buildings on campus. These new arrays will boost the generation capacity provided by our existing solar panels on buildings including King’s Gate, the Great North Museum Hancock, and the Cassie, Henry Daysh, and Devonshire buildings.
You can learn more about solar power and the University’s work in this area, on our blog.

How much energy will this project save?

It is anticipated that this project will reduce the University’s imports from the national electricity grid by an estimated 1.8 million kWh per year. This is expected to reduce Scope 1 and 2 CO2e emissions by over 380 tonnes a year. You can find out more about our carbon scopes and Newcastle University’s net zero ambitions on our Sustainability blog.

How long will this take?

We envisage a two-year programme to complete the works across 32 academic buildings and accommodation sites.


Merz Court Biofuel CHP

Enhancing our district heating Merz Court Energy Centre with a Biofuel Combined Heat and Power (CHP) engine.

What is the project?

Heating and powering our campus is one of the University’s largest sources of carbon dioxide emissions and so work to improve the efficiency of these systems is very effective at reducing our institution’s impact on the environment.

A major current project in this area is the installation of a biofuel combined heat and power (CHP) plant in Merz Court’s Energy Centre. This new system uses greener biofuel to generate electricity while also harnessing waste heat to warm up our buildings – greatly reducing carbon emissions as compared to conventional systems. You can learn more about this system on our blog.

How widely will these impacts be felt?

The CHP will have a substantial impact on carbon savings as Merz Court’s Energy Centre provides district heating to a whole swathe of the campus, including the:

  • Henry Daysh building,
  • Cassie building,
  • Stephenson building,
  • King Edward VII building,
  • Percy building,
  • Old Library Building,
  • And Merz Court itself!

How long will this take?

Work on the CHP’s design began in 2019 and the engine will be ready to provide heating and power for the next heating season (autumn/winter 2024).


Campus LED Project

Upgrading lighting across the University with power-efficient LEDs.

What is the campus LED project?

The campus LED project is a set of long-term estates improvement works designed to upgrade the general internal lighting of 44 high-use buildings across the University’s central campus. In addition to new LEDs replacing older, more energy-intensive bulbs, the project team will also install lighting controls, such as presence detection and daylight detection systems, to reduce unnecessary use of lighting.
Finally, as the project moves across all areas of many buildings, it will also be used as an opportunity to carry out remedial works where existing issues are identified.

How much energy will this project save?

Once complete, the project is expected to save 2,900,000 kWh of electricity per year. This will reduce the University’s consumption, lowering stress on the energy grid and allowing local solar generation to fulfil higher percentages of building supply.
Additionally, this power saving will also create a financial savings on energy bills significant enough that the project will pay itself back in 6 years and 5 months (a shorter amount of time than the project itself took to complete!).

How long will this take?

The project commenced in 2016 and is forecast to be completed by 2027. 22 of the 44 buildings have had retrofitted LEDs installed already, and new lighting controls are being worked in as the project progresses.
